Big Rock – Dixon
69kV Transmission Line Project
69kV Transmission Line Project

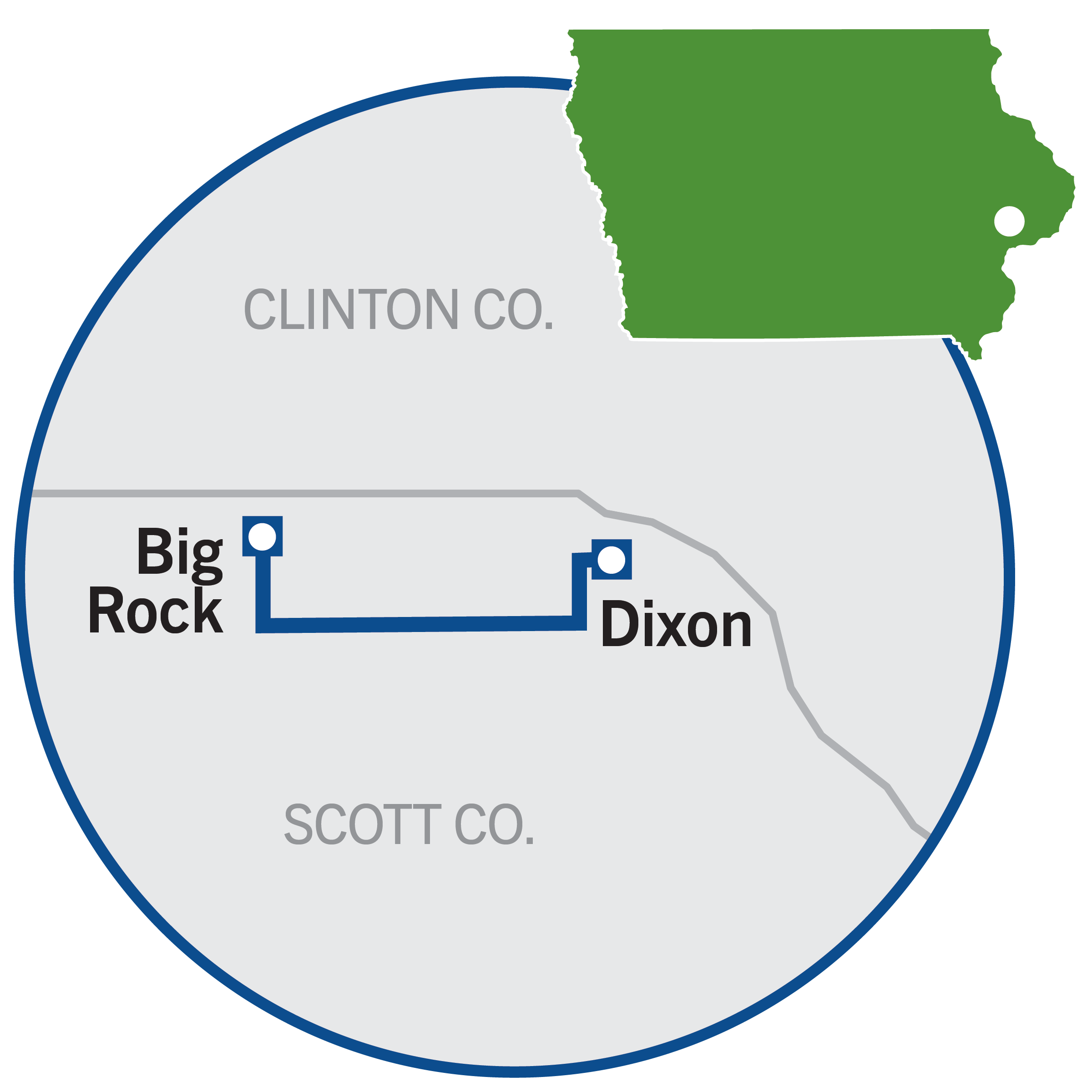

ITC Midwest is planning to build a new 69 kV (69,000 volt) electric transmission line that travels through Scott County from Alliant Energy’s future Big Rock Substation near Dixon to the Central Iowa Power Cooperative’s future Dixon Switching Station. The proposed line is approximately 3.8 miles long.
The proposed new transmission line is part of ITC Midwest’s continuing efforts to improve system reliability, enhance grid resilience to better withstand extreme weather, increase capacity of the electric transmission system, and reduce electric system congestion to improve grid efficiency. The new 69 kV line will be built to new construction standards and include lightning protection for enhanced system reliability. This line project is part of a comprehensive plan to upgrade the outdated 34.5 kV system to a modern 69 kV system across Iowa to meet the growing needs of energy consumers.
The Big Rock – Dixon project will provide important benefits and drive value to electric consumers. When completed, this transmission line will:
ITC Midwest seeks to minimize the impact of the line on existing land uses and is committed to protecting the environment. ITC Midwest will fully compensate landowners for any damages that occur during the construction process.
To minimize the footprint of the line, the company plans to use mostly wood monopoles with a few wood laminate and steel monopoles.
Under Iowa law, ITC Midwest cannot negotiate for easements until after the Iowa Utilities Commission holds a public information meeting. For this project, the public information meeting was held in Dixon in Scott County on August 13, 2026.
ITC Midwest representatives are now meeting with affected landowners in the proposed corridor to explain the process and their rights, and ultimately, to begin negotiations to secure voluntary easements. Landowners are compensated for permitting ITC Midwest to secure an easement on their property. ITC Midwest understands and appreciates the impact that new line construction has on landowners and pledges to treat all landowners with the utmost respect during this important process.
| Public information meeting | August 13, 2026 |
| Easement acquisition complete | Second quarter 2027* |
| If approved by Iowa Utilities Commission, construction begins | First quarter 2030* |
| Construction complete | Third quarter 2030* |
*These time frames are subject to change
